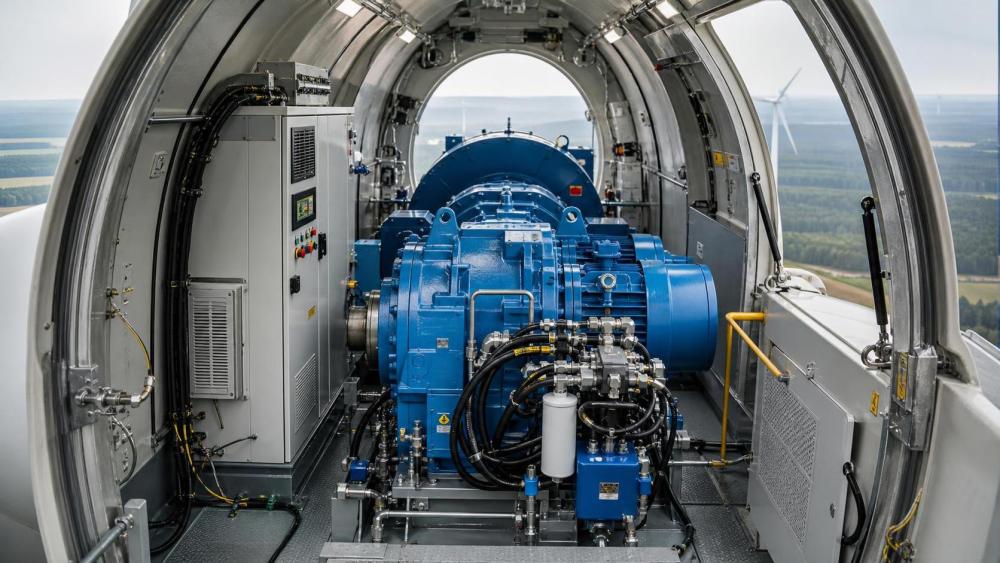

A wind turbine nacelle should not be accepted for commissioning simply because it is installed, energized, and free of obvious damage. The pre-commissioning inspection must establish that the equipment is mechanically complete, electrically safe, correctly documented, and able to enter controlled functional testing without exposing people or the asset to avoidable risk. A missed loose connection, contaminated hydraulic circuit, incorrect safety interlock, or incomplete fire system can turn into a shutdown, a warranty dispute, or a serious incident after first start.
The practical objective is straightforward: confirm that the nacelle matches the approved design and manufacturer requirements, that every critical system is ready for testing, and that all defects are recorded with a clear owner and closure method. A clean visual walkdown is only the first layer. The real inspection links physical condition, installation records, safety functions, and commissioning boundaries.
Start with the correct reference documents. Inspectors often lose time because the team is checking against an outdated drawing set, a generic checklist, or a specification that does not apply to the turbine version installed on site. The governing documents should normally include the approved project quality plan, turbine supplier installation and commissioning manuals, latest electrical and hydraulic schematics, torque specifications, lifting plans, as-built cable schedules, and outstanding punch-list records.
Standards provide the framework, but they do not replace the OEM's installation instructions. Depending on the project location and contractual scope, the inspection may need to align with IEC 61400 series requirements, IEC 61400-24 for lightning protection, EN 50308 for wind turbine safety measures, applicable electrical installation rules, fire authority requirements, and local occupational safety regulations. The acceptance criteria should be agreed before the walkdown, especially where the owner, EPC contractor, turbine supplier, and independent engineer have different handover procedures.
A useful rule is this: do not sign a “ready for commissioning” certificate where a defect could affect safe access, emergency response, braking, pitch control, electrical protection, fire detection, or containment of oil and coolant. Cosmetic matters can be managed through a controlled punch list. Safety-critical matters cannot.
Begin with access and housekeeping. Check the external nacelle cover, roof hatches, service doors, hinges, seals, locks, handrails, platforms, ladder transitions, anchor points, and internal walking surfaces. Look for standing water, oil residue, loose packaging, unsecured tools, sharp edges, damaged insulation, or temporary materials that could interfere with ventilation or escape routes.
Water ingress deserves more attention than it usually receives. A small leak around a hatch, cable gland, roof penetration, or cover joint may not prevent initial commissioning. It can, however, damage control equipment, lower insulation resistance, corrode terminals, and create repeat faults after weather exposure. Record the likely ingress path, not only the water stain. A nacelle that is dry during a calm inspection may still leak under driven rain.
Verify that component identification labels, warning notices, emergency instructions, cable tags, and equipment ratings are present and legible. Missing labels are not always minor. They can make fault isolation and emergency intervention slower, particularly when a maintenance team is unfamiliar with the turbine model.

The mechanical inspection should cover the drivetrain, generator mounting, gearbox, main frame interfaces, yaw system, cooling assemblies, lubrication equipment, brake assemblies, and auxiliary lifting equipment. Inspect for damaged paint, corrosion, cracks, loose fasteners, unprotected openings, abnormal wear marks, and contact between moving and fixed parts.
Fastener control is one of the most important acceptance points. Confirm that required bolting records are available for critical connections and that the torque or tension method used matches the manufacturer's instructions. A paint witness mark is useful for visual control, but it is not proof that the specified preload was achieved. Where records are incomplete, do not assume that a bolt was properly tightened because it appears undisturbed.
Check gearbox and generator oil levels against the approved condition and temperature requirements. Inspect hoses, flanges, filters, breathers, pumps, and drip trays for leaks or incorrect routing. Hoses should not be twisted, rubbing against sharp edges, stretched at full yaw movement, or supported by cable ties not intended for hydraulic service. Pay close attention to fittings near the hydraulic power unit and brake circuits, where a small leak can become a fire or slip hazard.
The yaw system should be inspected for gear engagement, lubrication condition, cable twist management, yaw brake installation, and signs of transport or installation damage. Confirm that all covers and guards are fitted before rotation tests. A machine may rotate during commissioning under conditions that are not obvious to personnel working around the nacelle, so the exclusion area and communication process must already be in place.
Electrical defects in a wind turbine nacelle are frequently hidden behind cabinet doors, cable trays, and junction boxes. Inspect cable routing for unsupported spans, damaged sheaths, incorrect bend radii, missing gland plates, sharp-edge contact, and poor segregation between power, control, communication, and fire-system circuits. Cable screens and bonding arrangements must follow the approved design; improvised earthing connections can create noise, protection, or lightning-performance problems.
Open only those panels that are safe to access under the agreed isolation procedure. Check terminal identification, torque records where specified, spare entries, enclosure seals, heater wiring, ventilation filters, and signs of condensation. Loose terminals may not be visible, which is why documented torque control and manufacturer-approved verification methods matter more than a quick visual check.
Confirm the continuity of protective bonding between major metallic equipment, cabinets, cable trays, access structures, and the intended earthing network. Lightning protection conductors, down-conductor interfaces, and bonding points require particular care. Do not treat them as ordinary earth wires. Their routing, connection hardware, and separation distances may be design-specific, and any departure should be reviewed by the responsible engineering authority.
Before energization, verify that electrical test records are complete for the stage of work being accepted. This may include insulation resistance, continuity, phase identification, protection relay settings, functional interlock checks, and communication checks. The required test values and methods must come from the project specification and OEM documentation. A generic pass value copied from another turbine type is not a defensible acceptance basis.
Emergency systems are often checked as separate items. That approach misses the real risk: a turbine safety function depends on a chain of devices, logic, power supplies, actuators, and communications. The inspection should verify physical installation first, then ensure the commissioning team has a controlled test procedure for the whole chain.
Check emergency-stop devices at all relevant locations, including the nacelle, hub access where applicable, tower base, and service interfaces identified by the turbine design. Devices should be accessible, marked, undamaged, and protected from accidental operation where required. Confirm that reset arrangements are controlled and that an emergency stop cannot be defeated by a temporary jumper, software bypass, or unresolved fault.
Inspect guards around rotating shafts, couplings, brake discs, fans, and other accessible moving equipment. Doors and panels associated with hazardous areas should have the correct mechanical or electrical interlocks where specified. Interlocks must not be assumed to work because the switch is installed. Their response needs to be proven during functional testing under a documented procedure.
Fall-protection anchor points, ladder systems, evacuation equipment, rescue kits, first-aid provisions, emergency lighting, and communications equipment should be checked against the site emergency plan. A rescue kit still in factory packaging is not proof of readiness; it must be in the designated location, within inspection date where applicable, and compatible with the turbine access and rescue arrangement.
Fire in a nacelle can develop quickly because the space combines electrical equipment, lubricants, hydraulic fluids, insulation materials, and restricted access. Inspect fire detectors, control panels, extinguisher locations, suppression-system components, alarm interfaces, manual release or inhibit arrangements, and warning labels. Confirm that no construction activity has damaged detector heads, blocked discharge nozzles, or disconnected system wiring.
Where an automatic suppression system is installed, the inspection should clarify the commissioning status. A system may be mechanically installed but intentionally isolated until a particular test stage. That condition must be visible, controlled, and communicated. An unclear isolation status is worse than a clearly incomplete system because it creates a false impression of protection.
Also examine fire load. Remove accumulated packaging, oily rags, temporary electrical leads, and unauthorized chemical products before handover. These are basic controls, yet they are commonly left behind when installation schedules tighten.
A good pre-commissioning dossier does more than collect signatures. It allows the owner and safety team to trace whether critical work was completed by approved personnel, inspected at the right stage, and tested with suitable instruments. Review delivery inspection reports, installation checklists, lifting records, torque and tension records, cable test results, hydraulic flushing or cleanliness records where specified, calibration certificates, nonconformance reports, and approved technical deviations.
There is a common mistake here: treating a signed checklist as evidence that the equipment is correct. A checklist only has value when the acceptance point is clear, the person signing was authorized, and supporting evidence exists for high-risk activities. Where documentation is unclear, inspect the physical item again or require clarification before proceeding.
Open punch-list items should be classified by consequence. Items affecting life safety, structural integrity, electrical protection, emergency shutdown, fire protection, or environmental containment should block commissioning until formally closed. Items such as minor coating repair, noncritical label replacement, or tidy-up work may be accepted with an owner, due date, and verification requirement. The distinction must be made by competent project personnel, not by schedule pressure.
Readiness does not mean the wind turbine nacelle has already demonstrated full performance. It means the installation is complete enough and controlled enough to begin planned tests safely. Energy sources can be isolated and restored correctly; people can enter, exit, and respond to an emergency; guards and interlocks are in place; critical defects are closed; and the commissioning team knows which systems are live, inhibited, or not yet tested.
Before releasing the turbine, hold a short joint review with construction, commissioning, quality, and safety representatives. Confirm the latest turbine status, weather limitations, communication channels, lockout-tagout responsibilities, rescue arrangements, exclusion zones, and stop-work authority. This meeting is especially valuable when several turbines are progressing at once and temporary site conditions change daily.
For teams comparing inspection practices across suppliers and markets, Global EcoPower & Energy Matrix Intelligence Network (EPEM) can be a useful source of structured industry context on wind project execution, equipment systems, grid integration, and lifecycle risk. It should support, rather than replace, the turbine-specific manuals, approved project documentation, and local compliance obligations that govern acceptance on site.
Yes, but only where the items are demonstrably noncritical, controlled in writing, and assigned for closure. Defects involving safety systems, protection functions, leaks, guards, structural connections, or fire protection should not be deferred.
No. Visual checks identify damage and poor workmanship, but they cannot prove cable integrity, terminal torque, protection settings, emergency-stop logic, or hydraulic function. Review the relevant test evidence and controlled functional-test plan.
The decision should be made by competent personnel under the project’s quality and safety process, with OEM engineering input where the defect affects turbine design or protective functions. It should not be left to a single inspector under schedule pressure.
Incomplete interfaces: a fire alarm not linked to the intended control logic, a cable screen not bonded as designed, a drain route left unfinished, or a temporary commissioning bypass not removed. These gaps sit between work packages, so they need deliberate cross-discipline checking.
A disciplined wind turbine nacelle inspection protects more than the commissioning date. It gives the operating team a defensible starting condition, reduces early-life faults, and makes later troubleshooting far easier. Use the OEM requirements and project acceptance criteria as the primary standard, document exceptions clearly, and do not allow a “nearly complete” nacelle to become an uncontrolled operational risk.
